K Line Northern Extension

Expanding fast, reliable rail service from the E Line north to Hollywood with new connections to four Metro rail lines and key destinations

Illustration of Crenshaw Northern Extension
Project Type
Rail
Current Phase
Planning
Estimated Project Completion
2047-2049

Metro is planning an underground extension of the K Line from the E Line north to Hollywood. The new rail service will connect with Metro’s B, C, D, and E Lines, serving six of LA’s busiest bus corridors and improving access to jobs, healthcare, and entertainment.

Fact Sheet

Status

On March 26 at 10:00 am, the Metro Board will consider the staff recommendation for selection of a Locally Preferred Alternative (LPA) for the K Line Northern Extension, an important milestone for this vital project.

Metro Board Meeting
When: Thursday, March 26, 2026 | 10:00 AM
Where: Metro Headquarters, One Gateway Plaza, Los Angeles, CA 90012
Watch Live: Stream online via the Metro Board webpage at boardagendas.metro.net

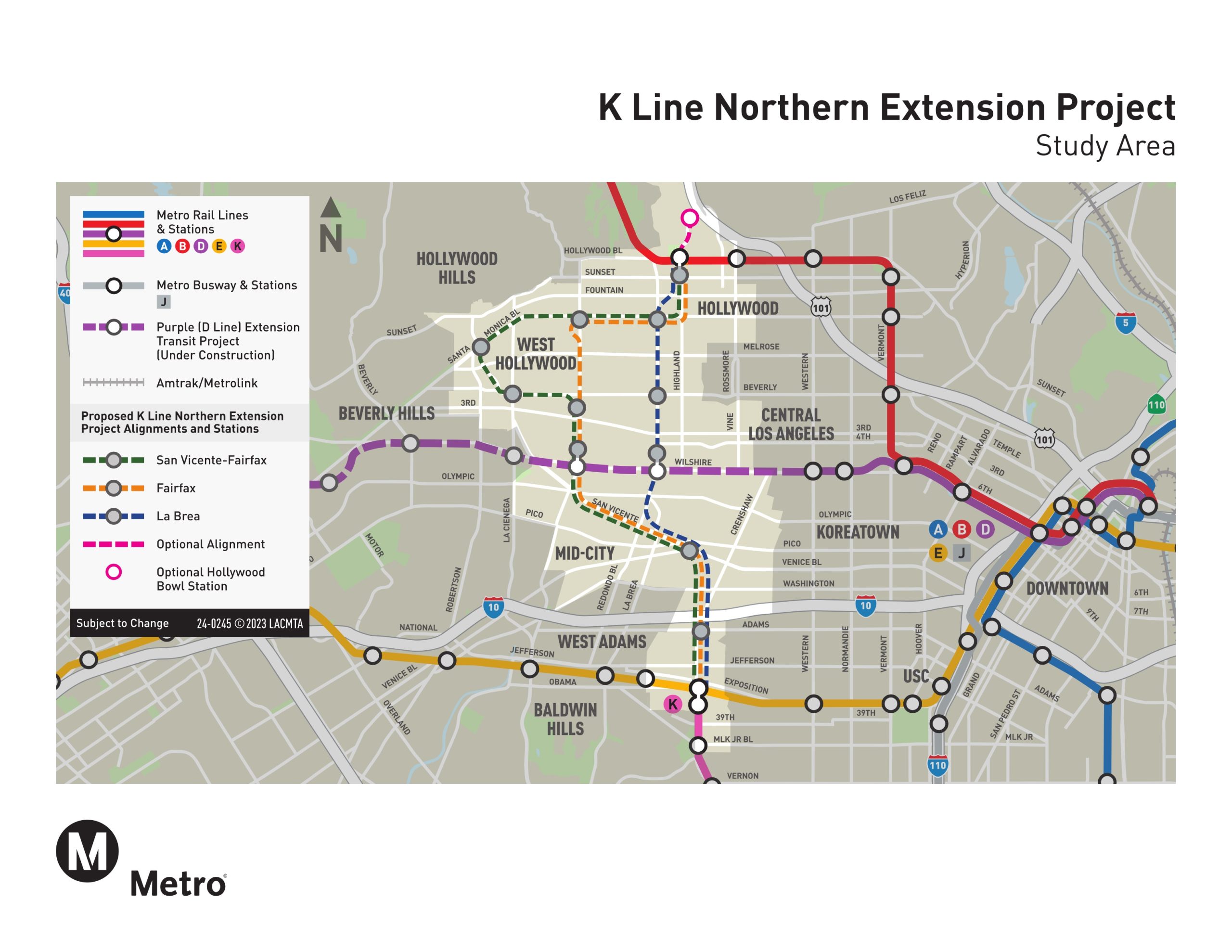

Project Map

The new rail service will connect with Metro’s B, C, D, and E Lines, serving six of LA’s busiest bus corridors and improving access to jobs, healthcare, and entertainment.

Project StoryMap

Metro’s updated Summer 2025 Story Map summarizes findings from the Mid-City Additional Alignment Analysis, Tunnel Safety, and Property Considerations reports that respond to community feedback raised during the Draft EIR period.

Recently Published Reports

In August 2025, Metro released three technical reports: Mid-City Additional Alignment Analysis, Tunnel Safety, and Property Considerations.

Project File Cabinet  

Access reports, summaries, and key project documents in one place.

Locally Preferred Alternative (LPA) Frequently Asked Questions

Find answers to common questions about the project milestone for LPA selection.

Summary of Engagement

Review summaries of public comments received during the Draft EIR comment period and Metro's additional outreach efforts conducted in response to community feedback.

Fair Political Practices Commission Correspondence

Attached correspondence received.

Timeline

2041-2049

Anticipated Opening of KNE

Construction funding becomes available in 2041, with the extension anticipated to open for service between 2047 and 2049.

2041-2049
2025/2026

Metro Board to Consider LPA

Metro Board to consider selection of Locally Preferred Alternative and next steps.

2025/2026
2025

Metro Prepares New Technical Studies

Metro conducted additional outreach, prepared and published new technical studies to address community concerns from Mid-City residents raised during the Draft EIR comment period including: Mid-City additional alignment options, property considerations, and tunnel safety. Metro hosted community meetings in Summer/Fall to share findings and continued engaging with Mid-City residents to gather feedback.

2025
2024

Metro Releases Draft EIR

Metro released the Draft EIR for public review and held hearings and meetings, receiving more than 1,300 community comments.

2024
2022

K Line Opens

The K Line opened, creating the foundation for its future northern extension.

2022
2021

Metro Launches Public Scoping

Metro launched the environmental review process with public scoping meetings to gather early community input.

2021
2020

Metro Board Directs Staff to Prepare Draft EIR

Metro advanced planning studies with Advanced Alternatives Analysis (AAA) Screening Study, further refining evaluation of potential alignments for a northern extension. Metro Board directed staff to prepare a Draft Environmental Impact Report (EIR).

2020
2018

Metro Prepares Feasibility/Alternatives Analysis (AA) Study

Metro prepared Feasibility/Alternatives Analysis (AA) Study, evaluating potential alignments for a northern extension of the K Line.

2018
2016

Voters Approve Measure M Funding

Voters approved Measure M, dedicating $2.24 billion for the K Line Northern Extension.

2016
2014

Construction Begins on the Original K Line

Construction began on the original K Line (then called the Crenshaw/LAX Transit Corridor Project).

2014

Frequently Asked Questions

What is a Locally Preferred Alternative (LPA)?

A Locally Preferred Alternative is the route selected by the Metro Board of Directors that best meets the project’s goals, objectives, and community needs, based on technical analysis and public input.

What type of analysis and engagement was conducted to inform the LPA?

Metro is currently evaluating the K Line Northern Extension (KNE) project under California Environmental Quality Act (CEQA) and prepared a Draft Environmental Impact Report (EIR), which evaluates multiple alternatives. After a 60-day public comment period on the Draft EIR, including public hearings and community meetings, staff analyzed all feedback received and conducted additional technical analysis and community engagement in response to comments on the Draft EIR.

What alignments and options are being considered for the LPA selection?

Metro has evaluated several alignment options in the Draft EIR (2024) and Mid-City Additional Alignment Analysis (2025), including:

  • San Vicente-Fairfax Alignment: would extend the K Line underground approximately 9.7 miles north from the Metro E Line Expo/Crenshaw Station to the Metro B Line Hollywood/Highland Station.
  • Fairfax Alignment: would extend the K Line underground approximately 7.8 miles north from the Metro E Line Expo/Crenshaw Station to the Metro B Line Hollywood/Highland Station.
  • La Brea Alignment: would extend the K Line underground approximately 6.2 miles north from the Metro E Line Expo/Crenshaw Station to the Metro B Line Hollywood/Highland Station.
  • Hollywood Bowl Design Option: would extend the K Line underground to the Hollywood Bowl, an alternate terminus to the Hollywood/Highland Station.
  • Mid-City Alignment Options: based on community feedback, Metro evaluated 12 alignment options in Mid-City, to explore routes that could minimize subsurface easements below historic neighborhoods, and compared options based on potential subsurface easements, tunnel length, travel times, and changes to station footprints.
What has happened since the Draft EIR public comment period closed?

Since the 60-day public comment period on the Draft EIR ended in September 2024:

  • Compilation of Comments: All written and oral comments were reviewed and compiled.
  • Additional Technical Analysis & Community Engagement: In response to key concerns raised during the Draft EIR comment period, Metro conducted additional technical analysis and community engagement on tunnel safety, property concerns, and additional alignment options in Mid-City. These reports were published in Summer 2025.
  • Mid-City-Specific Outreach: Metro organized additional outreach and engagement focused on concerns raised by residents in historic Mid-City neighborhoods, particularly around alignment options, property considerations, and tunnel safety, including community meetings and updated technical materials.
  • Cost Benefit Analysis: Metro conducted a Cost Benefit Analysis (CBA) to compare the Draft EIR alignment alternatives based on expected costs and benefits, including a Weighted Benefits Analysis and a Benefit-Cost Ratio.
  • Staff Evaluation and Recommendation for LPA: Staff has weighed multiple factors (e.g. technical analyses environmental impacts, ridership and project benefits, costs, constructability, funding, CBA findings), and public comments and stakeholder input to evaluate how the alignment options studied align with project goals and objectives to inform the LPA recommendation.
  • Board Consideration: The Metro Board will consider the staff recommendation for the LPA and vote at a public meeting where the public may comment.
What factors are used to select an LPA?

The selection of an LPA is based on technical and policy considerations, such as:

  • Project goals and objectives
  • Findings from the Draft EIR, including environmental impacts and proposed mitigation measures, and additional analysis completed in 2025 in response to community concerns on the Draft EIR
  • Feedback received during the Draft EIR comment period and subsequent community engagement
  • Project costs, funding availability, and financial feasibility
  • Ridership projections and mobility improvements
  • Input from stakeholders
  • Constructability and operational feasibility
  • Consistency with Metro policies and regional planning goals
  • Proposed construction timeline
  • Cost Benefit Analysis (CBA)
