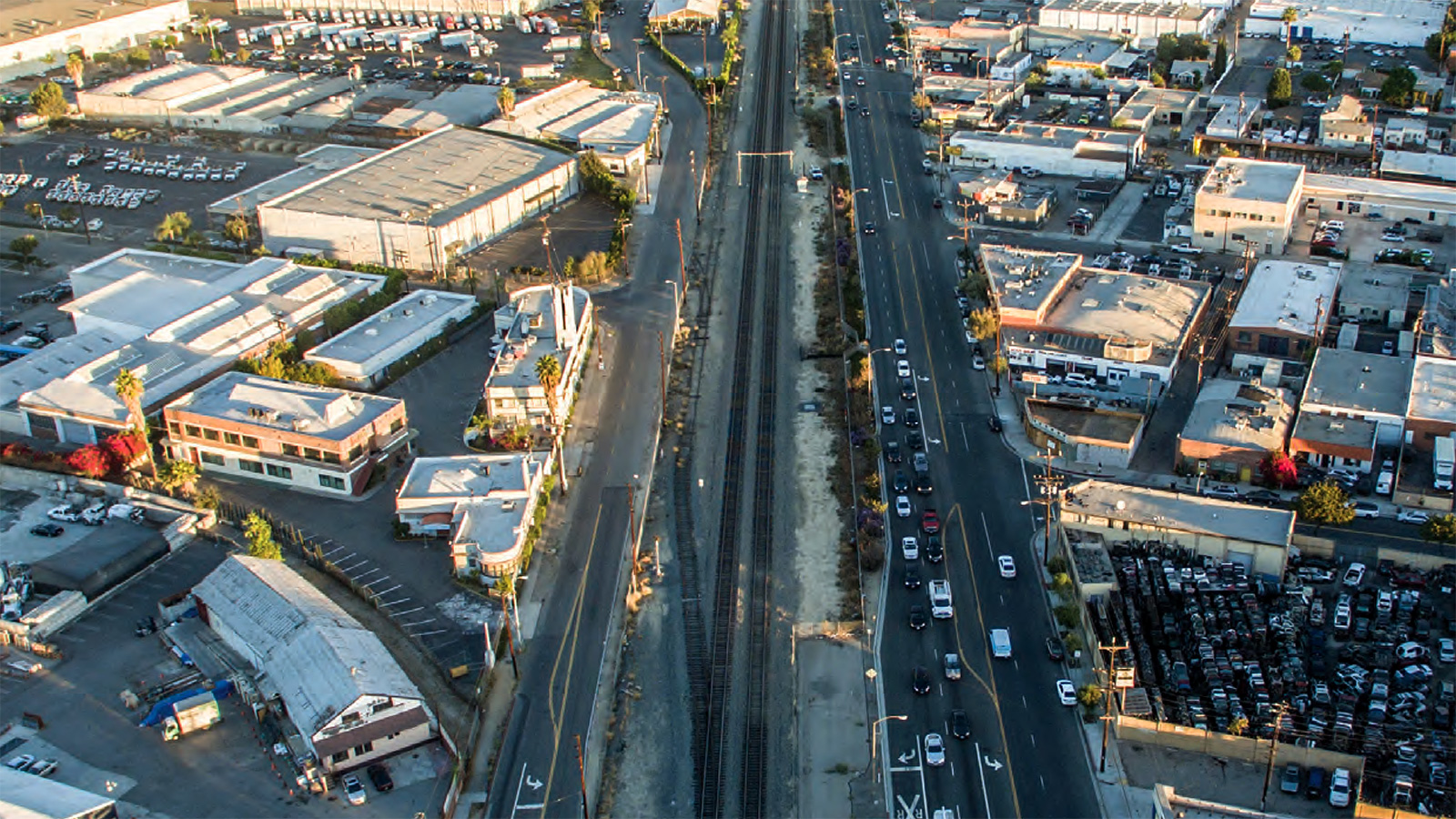

Doran St Grade Separation Project

Enhances safety, mobility and access near the Doran St rail crossing through a new roadway connection and future grade-separated enhancements for vehicles, pedestrians and bicyclists.

Project Type
Rail
Current Phase
Design

Metro is advancing the Doran St Grade Separation Project to enhance safety, mobility, and access at a high-risk rail crossing at Doran St. The project area includes industrial facilities, businesses, and residences located near the Los Angeles–Glendale border, south of SR-134 and east of the Los Angeles River.

The Doran St cross is among the most hazardous in Los Angeles County and the state due to heavy vehicle and truck traffic, frequent train activity, and pedestrian and bicycle movements. Currently, approximately 82 Metrolink, Amtrak, and freight trains travel through the corridor weekly, resulting in crossing gates being down roughly 7.5 hours per week. With future rail expansion, weekday train volumes could triple by 2040. Due to existing safety concerns, the California Public Utilities Commission (CPUC) has directed the at-grade crossing to close.

The project will replace the existing crossing with a new grade-separated roadway connection between West San Fernando Rd and Fairmont Av, separating vehicles and roadway users from active rail operations. The new bridge will maintain industrial access for large trucks and emergency responders while improving safety and reliability.

The bridge will serve vehicles only. Pedestrians and bicyclists will use designated routes, including Broadway/Brazil, following the crossing closure. A separate bicycle and pedestrian bridge is planned for the future.

In development since 2012, the project completed environmental reviews under CEQA in 2019 and NEPA in 2025, finalized design, and secured funding at the September 24, 2026, Metro Board Meeting. Construction is anticipated to begin in Fall 2026.

Status Update

Metro has completed environmental review and completed the final design and is preparing for construction in Fall of 2026. The Doran St Grade Separation Project will build the new vehicle connection between West San Fernando Rd and Fairmont Av.

The safety and access enhancements will be delivered in three phases:

  • Doran St Grade Separation (2026-2030): a new roadway connection between West San Fernando Rd and the Fairmont Av bridge, extending West San Fernando Rd beneath SR-134 and across Verdugo Wash on a new bridge to connect to the existing Fairmont Av Bridge.
  • *Salem and Sperry Overpass (TBD)*Depending on funding availability: A new overpass connecting Salem and Sperry streets.
  • *Biking / Pedestrian Bridge (late 2027-early 2032)*Depending on funding availability: A dedicated bicycle and pedestrian bridge over San Fernando Rd and the rail corridor at Doran St providing access to the Glendale Narrows Riverwalk and LA River.

Design & Technical Development

New Connections in LA-Glendale

The Doran St Grade Separation Project extends West San Fernando Rd beneath SR-134 and across Verdugo Wash to connect with the Fairmont Av bridge. The Doran St rail crossing will close after the connection opens.

Follow Design Progress

Metro has completed the final design and is preparing for construction. Early work is expected mainly in the Verdugo Wash, while the Doran St crossing remains open.







Stay Connected

Stay informed as the project advances. Sign up for updates about project milestones, future activities, and upcoming community information.

Frequently Asked Questions

What is the purpose of this project?

To enhance safety and access at the high-risk Doran St rail crossing near the Los Angeles–Glendale border. By separating drivers, pedestrians, and bicyclists from the active rail corridor, the project reduces conflicts with trains, strengthens connections between Glendale and Los Angeles, and supports more reliable travel for everyone, including emergency responders. It is mandated by the California Public Utilities Commission (CPUC).

Why are improvements needed?

The Doran Street at-grade crossing is one of the most hazardous in Los Angeles County. About 82 passenger and freight trains travel through the corridor each day, and the Doran St crossing gates are down about 7.5 hours each week. The California Public Utilities Commission has directed that safety improvements be made at this location. The project provides replacement access without leaving the industrial area dependent on a single access route while closing the at-grade crossing.

How many phases are planned?

The safety and access improvements will be delivered in three phases:

  • Doran St Grade Separation Project (2026-2030): A new roadway connection between W San Fernando Rd and the Fairmont Ave bridge, extending West San Fernando Rd beneath SR-134 and across Verdugo Wash on a new bridge to connect to the existing Fairmont Ave bridge.
  • Salem and Sperry Overpass* (TBD): A new overpass connecting Salem and Sperry streets.
  • Bicycle and Pedestrian Bridge* (late 2027-early 2032): A dedicated bicycle and pedestrian bridge over San Fernando Rd and the rail corridor at Doran St providing access to the Glendale Narrows Riverwalk and LA River. *Depending on funding availability.

As the improvements are completed, the existing at-grade rail crossings at Doran St will be permanently closed to vehicular traffic but with enhanced west-east access for pedestrians and cyclists along San Fernando Rd in Atwater Village and City of Glendale.

What will the Doran St Grade Separation Project be build?

The Doran St Grade Separation Project extends West San Fernando Road beneath SR-134 and across Verdugo Wash on a new bridge, connecting to the existing Fairmont Avenue bridge. The work also includes new roadways, sidewalks, accessible ramps, lighting, signals, and drainage to create a safer, more connected route across the corridor.

How will construction affect access?

Early construction is expected to occur mainly in the Verdugo Wash and nearby Caltrans areas, with the Doran St crossing remaining open. A later stage will require closure of the Doran St at-grade railroad crossing to motorists, pedestrians and bicyclists. During that period, people who need to cross the tracks will need to use Broadway/Brazil.

Will freeway ramps or business access close?

Freeway ramps are expected to remain open during construction of the Doran St Grade Separation Project, although short-term lane shifts or reductions may occur on Doran St. The project is designed to maintain access to nearby businesses and industrial properties, including large trucks. During the Doran St closure, truck and vehicle traffic needing to cross the tracks will use Broadway/Brazil.

Can pedestrians and bicyclists use the new roadway?

No. The new Doran St Grade Separation Project is for vehicles only. When the Doran St at-grade railroad crossing closes, pedestrians and bicyclists will use Broadway/Brazil to cross the railroad tracks. A separate future bicycle and pedestrian bridge is planned to provide a dedicated connection across the rail corridor, but its construction schedule and funding has not yet been confirmed.

When will more information be available?

Metro will provide additional information about construction, traffic, and detours once confirmed. Community members are encouraged to sign up for project updates to receive advance notification that may affect travel or local access.

Documents

Folder
Name
Type
Name of the document if it’s long
Description of folder if the description is too long then it will
Description of folder if the description is too long then it will
1.25GB
Download
Future

Future Improvements

The Salem/Sperry overpass and a dedicated bicycle and pedestrian bridge are planned for later phases. Schedules and funding are still to be determined.

Future
Fall 2026

Doran St Grade Separation Project construction anticipated to begin

The first phase will construct the new roadway connection between West San Fernando Road and Fairmont Avenue. Early work is expected to occur primarily in Verdugo Wash and nearby Caltrans areas. The Doran St crossing is expected to remain open during the early construction stages.

What to Expect During the Doran St Grade Separation Bridge Construction (Phase A)

Stage 1 – Verdugo Wash Work (approximately 1 year): Work will occur primarily within Verdugo Wash. The Doran St crossing will remain open, and no direct impacts are anticipated to normal street traffic, pedestrian/bicycle travel or business access. Construction vehicles and activity may be visible in the area.

Stage 2 – Bridge and Roadway Construction (approximately 1 year): Crews will construct the bridge within Verdugo Wash and the roadway beneath SR-134. The Doran St crossing will remain open. Major traffic or business-access impacts are not anticipated, although nearby users may notice construction traffic.

Stage 3 – Temporary Doran St Crossing Closure (approximately 3 months): The existing Doran St crossing will close to motorists, pedestrians and bicyclists before the new bridge opens. Anyone who needs to cross the railroad tracks will use Broadway/Brazil. Freeway ramps are expected to remain open, although temporary lane shifts or single-lane reductions may occur for restriping and related roadway work.

Stage 4 – New Bridge Opens / Final Crossing Work (approximately 7 months): The Doran St Grade Separation Bridge will open to motor vehicles while final work continues near the former Doran St crossing. Motorists can use the new bridge or Broadway/Brazil; pedestrians and bicyclists will continue to use Broadway/Brazil to cross the tracks.

Business and truck access will be maintained throughout construction. During the approximately 3-months Stage 3 closure, trucks and other vehicles that need to cross the tracks will be directed south to Broadway/Brazil.

Fall 2026
2025

Federal environmental review completed

Metro completed federal environmental clearance for the project.

2025
2019

State environmental review completed

Metro completed federal environmental clearance for the project.

2019

Get Involved

Help shape this project for good. We want to hear from you:

Got questions or ideas? Our project team is here to listen.

Got questions or ideas? Our project team is here to listen.

Our team is here to support your questions and help you understand what this work means for your community. We can help explain design options, features, and how community feedback shapes each stage of the work.

Channels are monitored to make sure you receive timely support.

Scroll to Top
